A kitchen remodel typically takes 8 to 12 weeks of construction, with another 1 to 3 months for planning and permits before work even begins. That gap, weeks of construction against months of preparation, is where most timeline surprises start.
Homeowners who start without a clear schedule tend to run into two problems at once: the project takes longer than planned, and the budget grows along with it. Both issues usually trace back to the same cause: a scope and sequence that were never mapped out before demolition began.
This guide walks you through each phase of a kitchen remodel, from planning and permits to demolition, construction, and the final walkthrough. Each phase is covered on its own, applying equally to a light refresh of an existing layout and to a full teardown and rebuild.
A defined schedule will not remove every delay, but it puts a homeowner in position to plan around the ones that matter, order materials early, and keep the household functioning while the work is underway.
Every kitchen remodel moves through the same five phases, though the time spent in each one shifts with the scope of the project.

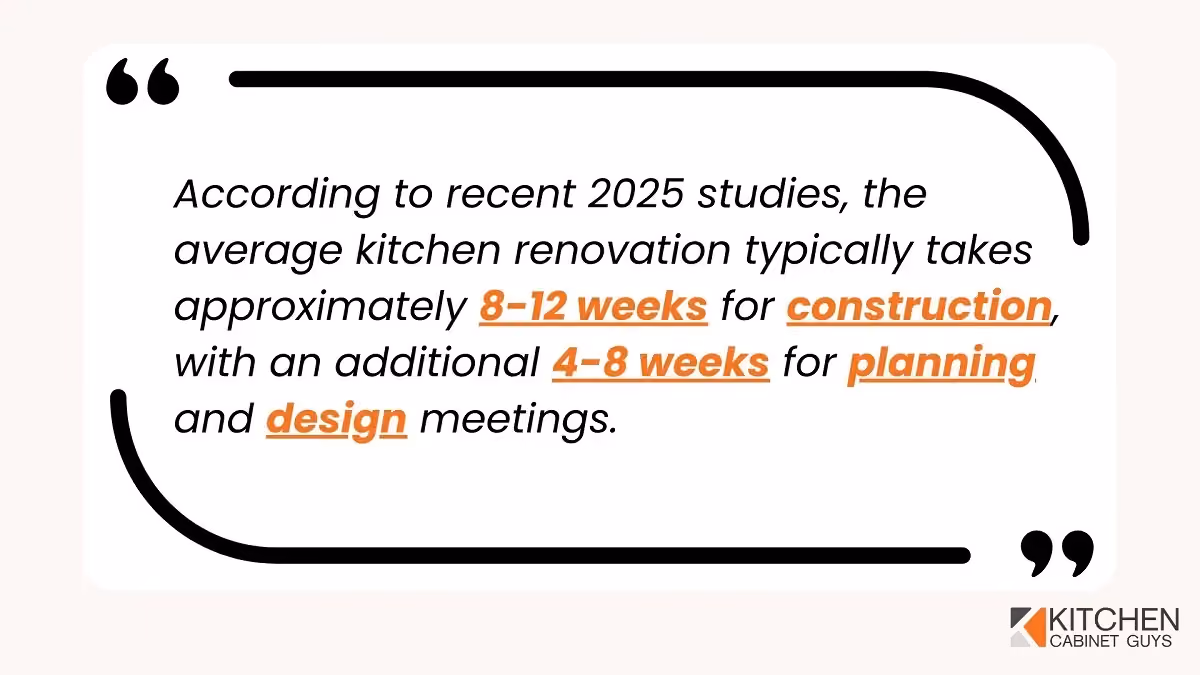

The kitchen remodel timeline can vary dramatically based on several factors. While some minor updates might be completed in just a few weeks, major renovations involving structural changes to your kitchen layout can take 6 months or more. The average time for a complete kitchen remodel depends on the scope of the project and several other key factors:
The table below lays out each phase in sequence, from the first planning meeting to the final walkthrough, along with the work completed at each stage.
These ranges assume a standard scope. A kitchen with a layout change, a structural wall, or a fully custom cabinet order will land toward the longer end of each phase.
The five phases outlined above are broken down into a week-by-week timeline below, starting with the planning decisions that shape the rest of the project.
This is where everything starts, and this step matters more than most homeowners expect. Rushing through the early planning stages leads to headaches later. Taking the time upfront will help keep your renovation smooth and on schedule. Here's what you’ll handle during this part of the process:
1. Setting goals and budget (1-2 weeks)
2. Hiring professionals (2-4 weeks)
3. Design development (2-6 weeks)
4. Permit application (2-4 weeks)
Quick tip: Order cabinet samples early. You’ll want time to see them in your kitchen’s lighting and compare finishes before locking anything in. What you pick will affect both your costs and how long the whole remodel takes.

This stage usually overlaps with planning. Once your design’s approved, it’s time to get all your materials on the way. You want everything ready to go once construction kicks off.
1. Cabinet ordering (4-12 weeks)
2. Appliance ordering (2-8 weeks)
3. Ordering other materials (2-6 weeks)
Important: Hold off on tearing out your old cabinets until most, if not all, of your materials have arrived and you’ve had a chance to inspect everything. Delivery times can shift for all kinds of reasons, and getting stuck without a working kitchen while you wait on back-ordered items can seriously throw off your whole renovation.

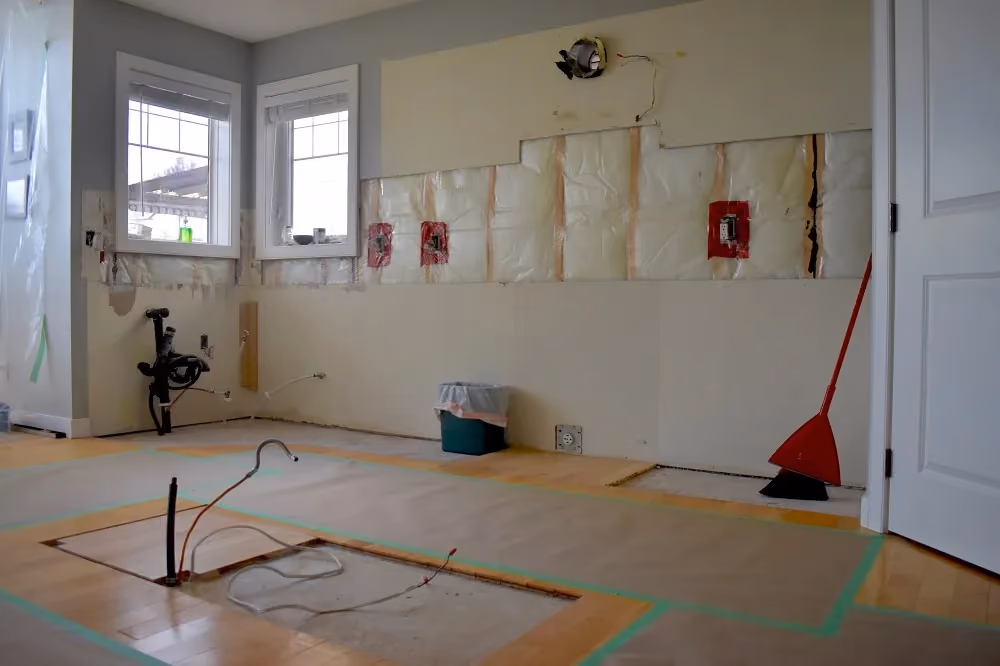

Now the action kicks off. This is where your kitchen starts looking less like a home and more like a work zone. Here’s what happens first:
1. Preparation (2-3 days)
2. Demolition (3-5 days)
3. Major structural changes (1-2 weeks, if needed)
4. Rough-in work (1-2 weeks)
5. Drywall and painting (1 week)
6. Flooring installation (2-3 days)
Pro tip: Don’t skip a second inspection before closing up the walls. If there’s a plumbing issue and you have to open things back up later, it’ll cost time and money. A quick check now can save you a headache later.

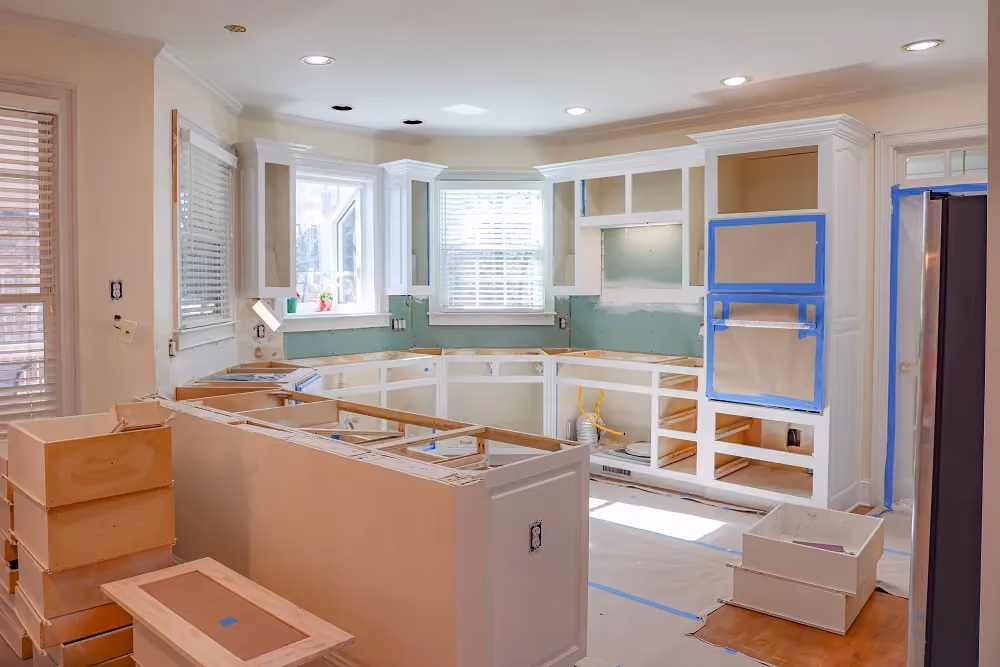

This is when your kitchen finally starts looking like something again. The finishes come together, and your design takes shape.
1. Cabinet installation (3-5 days)
2. Countertop fabrication and installation (2-3 weeks)
3. Appliance and fixture installation (2-5 days)
4. Backsplash installation (2-3 days)
5. Finishing details (3-7 days)
Pro tip: Make sure your construction schedule takes into account that countertop templating can’t happen until the cabinets are fully installed, and sinks can’t be set until the counters are in. This step-by-step process means planning ahead is key if you want to avoid delays that could throw off your entire kitchen remodel.

The last phase of the kitchen renovation process brings everything together for your entire kitchen:
1. Final inspections (1-3 days)
2. Touch-ups and adjustments (1-5 days)
3. Thorough cleaning (1-2 days)
4. Organizing and moving in (1-2 days)
These tips split into two windows: decisions to lock in before the first hammer swings, and habits that keep the schedule intact once work is underway.
1. Make all material decisions before starting
2. Create a detailed construction schedule
3. Establish clear communication channels
4. Consider seasonal timing

1. Be available for questions
2. Expect the unexpected
3. Minimize changes after construction begins
Five recurring causes account for most of the delays homeowners run into, ranging from material lead times to conditions no one can plan around, like weather.
1. Material delays when ordering materials
2. Hidden problems during demolition
3. Inspection and permit delays
4. Weather issues
5. Contractor availability and scheduling conflicts

If the average kitchen renovation timeline seems too lengthy or disruptive, consider cabinet refacing as a faster alternative:
Kitchen Cabinet Guys is ready to serve all of your cabinet refacing needs wherever you are in the Greater Chicago Area!
The two videos below offer kitchen design inspiration and a step-by-step DIY walkthrough, helping homeowners who want to see the process before starting their own.
Need inspiration? This video covers modern kitchen design ideas and finish options worth considering for your remodel.

For those who seek advice on remodeling the kitchen with their own hands (it’s possible if you are handy!), we invite you to watch this video for a full walkthrough of the process.
Have a nice watch!
Remodeling your kitchen takes time, but planning each phase carefully helps you stay on track. Most projects take 3-6 months from the first ideas to the final walkthrough, and rushing through the process often leads to bigger delays.
The key is to give yourself enough time to plan properly, choose the right materials, and work with experienced pros. A well-done kitchen upgrade will last for years and feel well worth the wait.
If you’re looking for something faster that still makes a big impact, cabinet refacing is a great option. In just a few days, you can give your kitchen a whole new look without the long timeline.
Ready to start planning your kitchen transformation? Contact us today for a free consultation, and let us help you create a realistic timeline for your dream kitchen!
Construction usually lasts 8-12 weeks, with planning taking another 1-3 months. Larger remodels with structural changes may stretch to 6 months or more total, while smaller updates might wrap up in 4-8 weeks.
Even with no delays, a full remodel will take at least 4-8 weeks of construction and 2-3 months of prep. That’s assuming all materials arrive on time and nothing unexpected comes up.
It depends on your tolerance for disruption. While not necessary, living elsewhere during major renovations reduces stress. If staying, set up a functional temporary kitchen elsewhere in your home.
January and February are typically the best window for availability with Kitchen Cabinet Guys, since that’s our slowest stretch of the year. March through May is our busiest season, so booking outside that window typically means a shorter wait to get started.
Use stock materials, work with a design-build team, make all decisions before work starts, and stay available to answer questions quickly.
A renovation updates how your kitchen looks without changing the layout. A remodel involves structural changes like moving plumbing or walls, and usually takes longer to complete.
Custom cabinets and structural changes to the layout are often the biggest factors affecting the project timeline. A cosmetic refresh using stock materials can wrap up in a few weeks. Add custom cabinetry and a layout change together, and the timeline can easily double.
